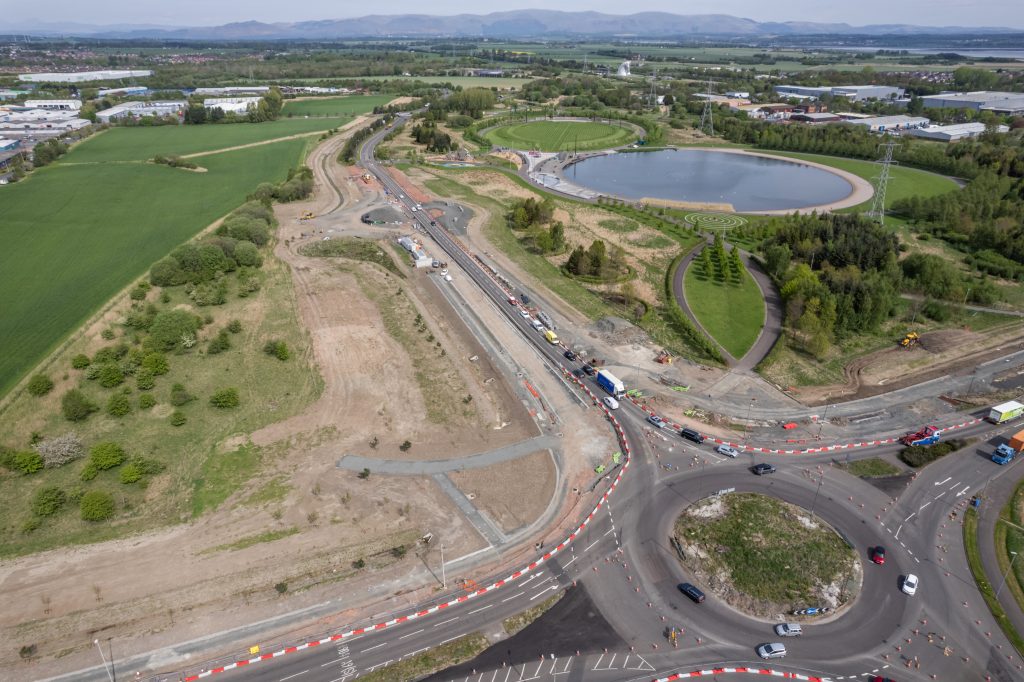

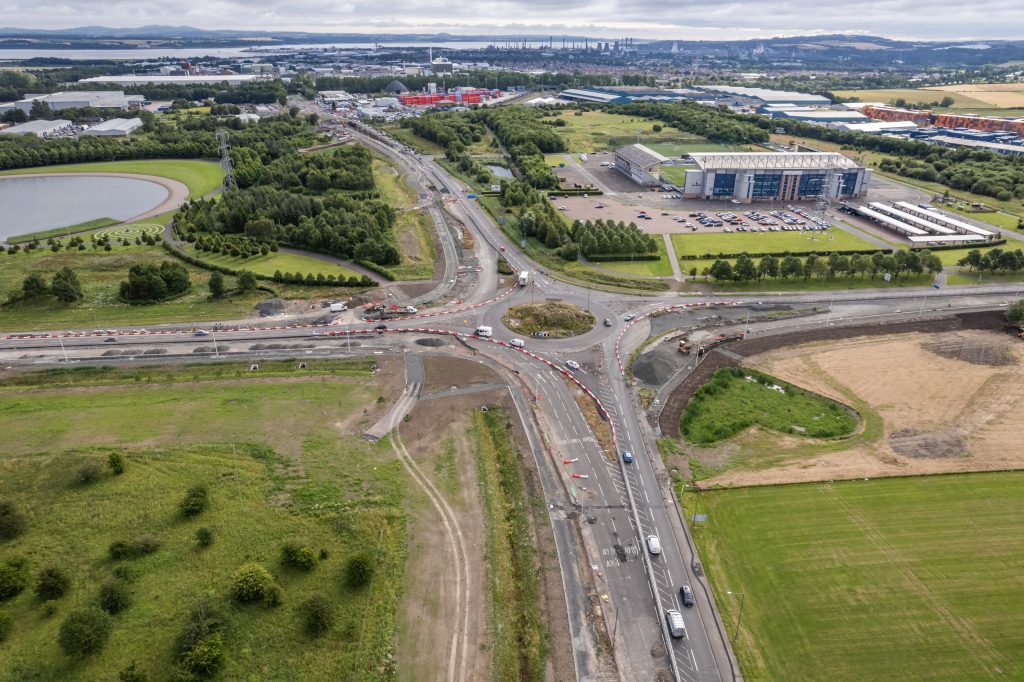

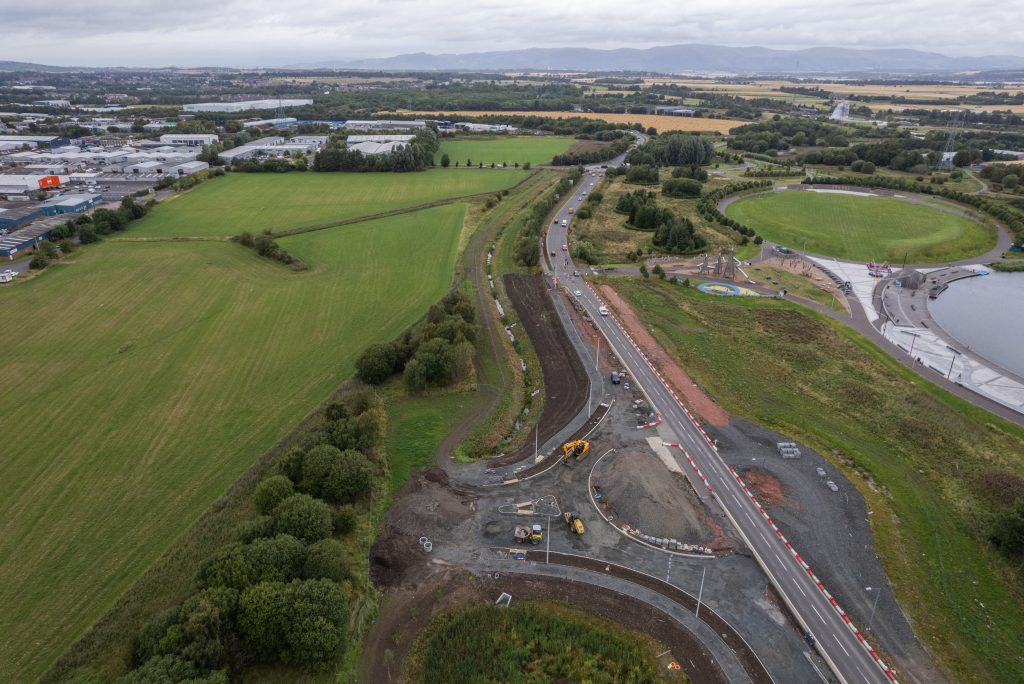

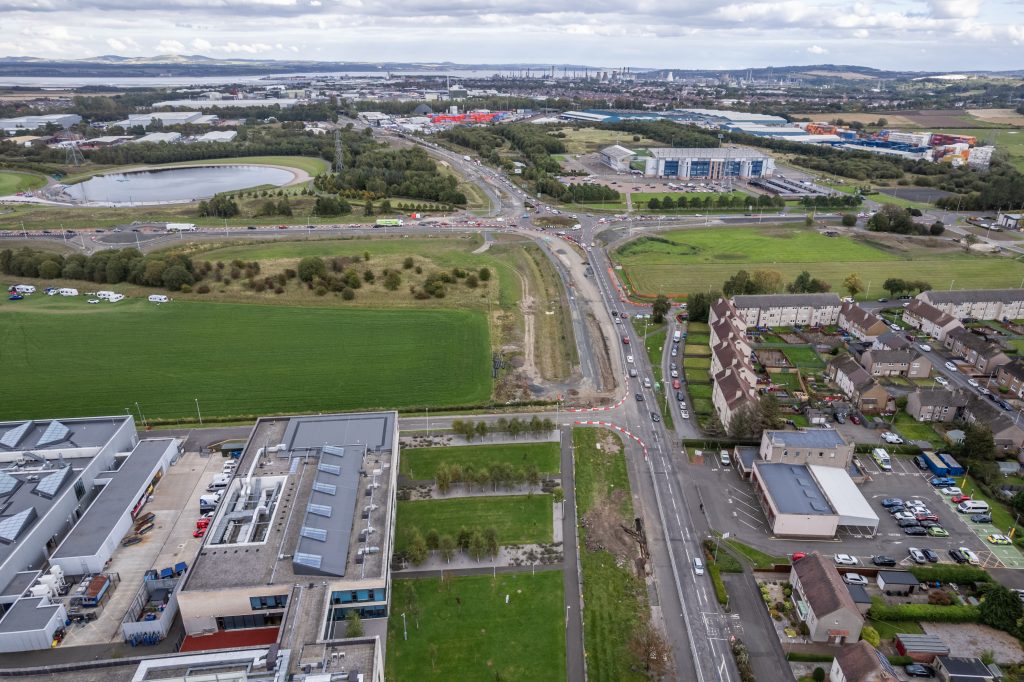

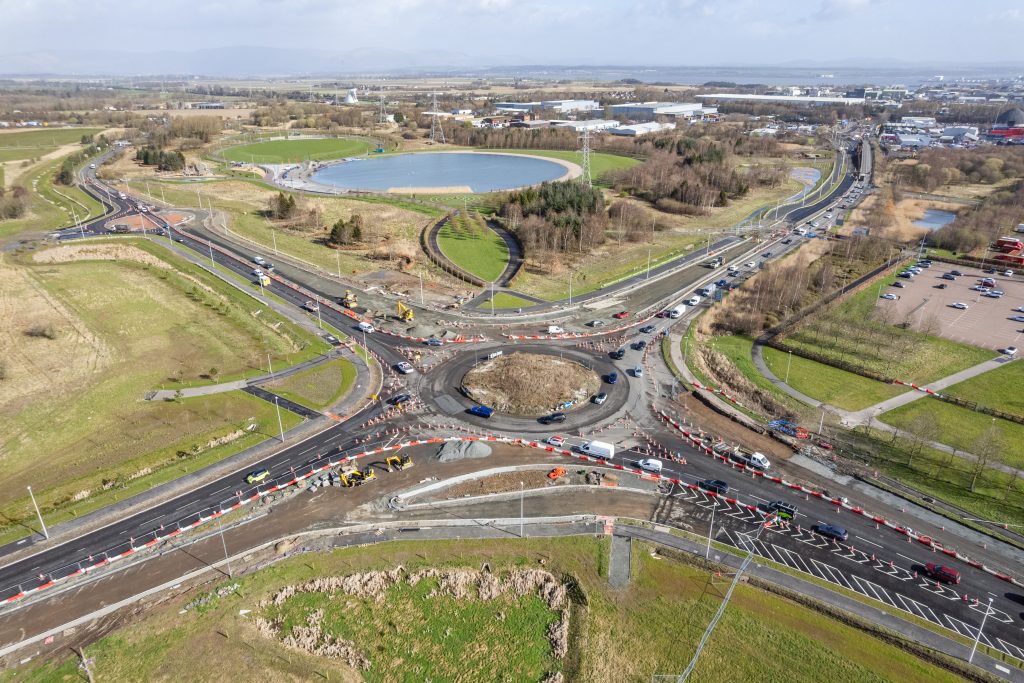

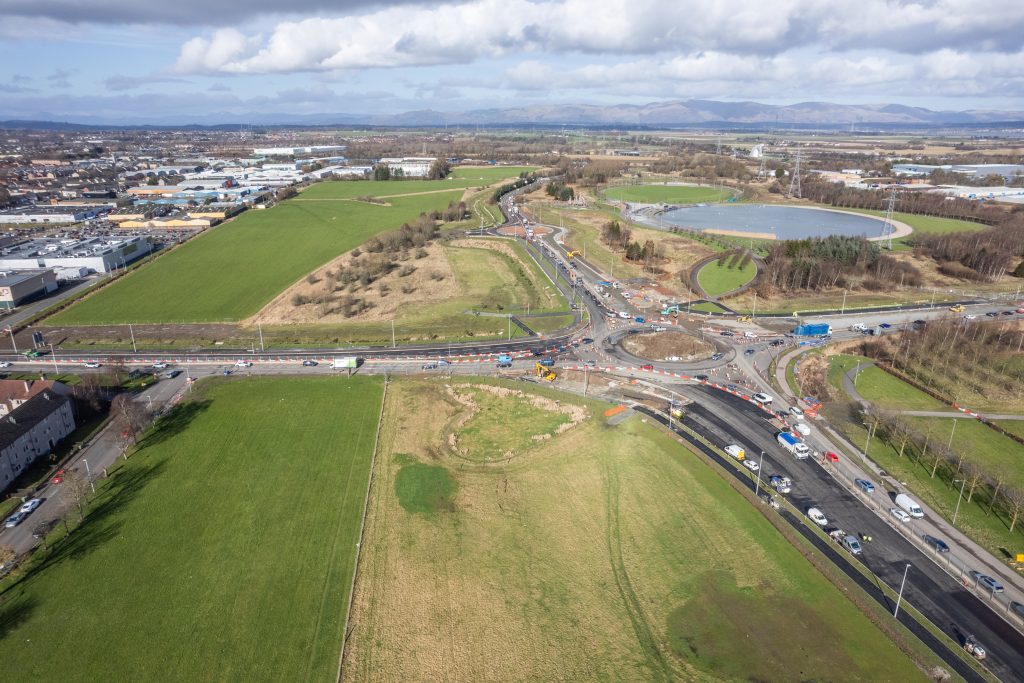

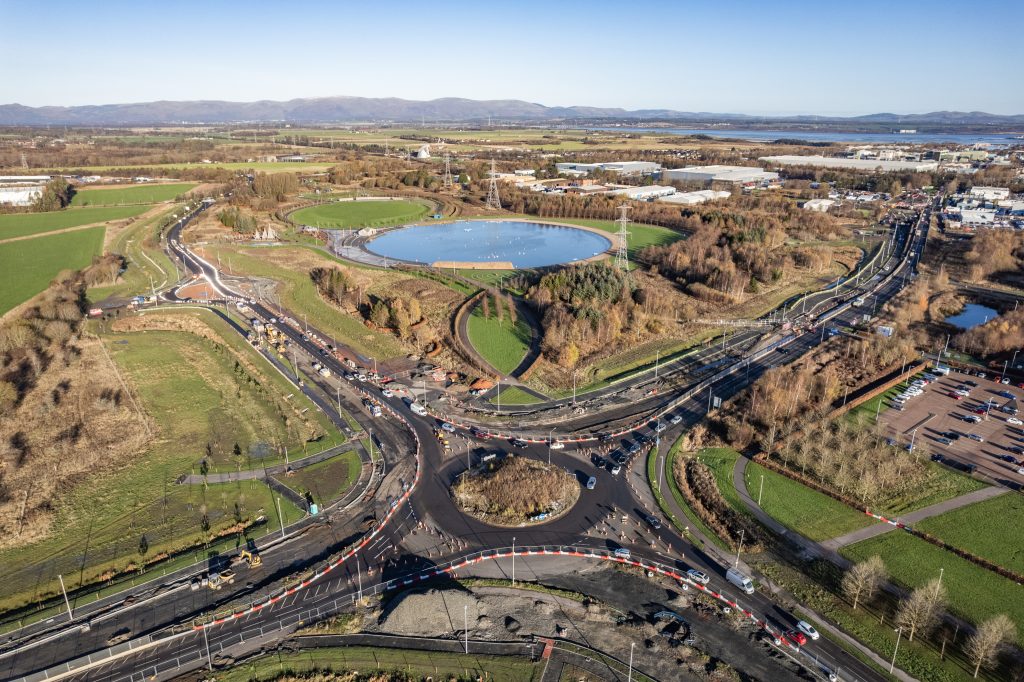

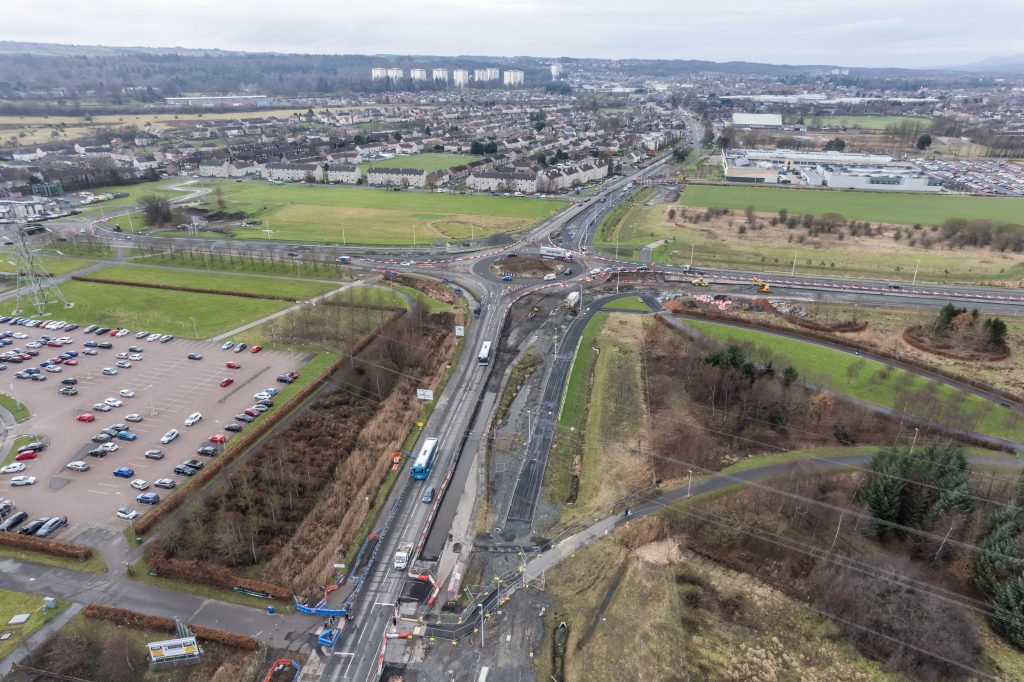

Work started on site on August 2023. Here we will be posting monthly project updates to keep you informed of progress.

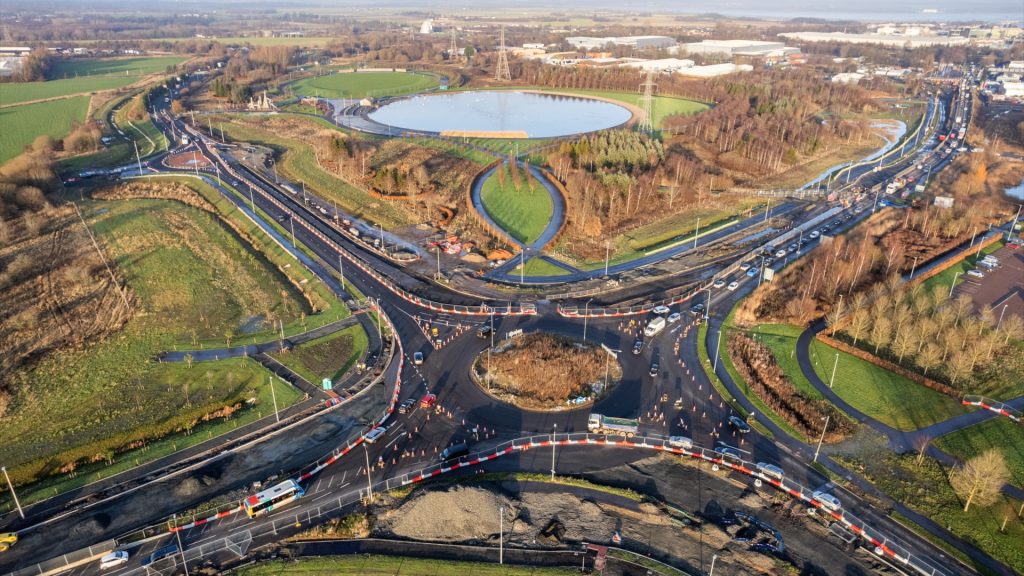

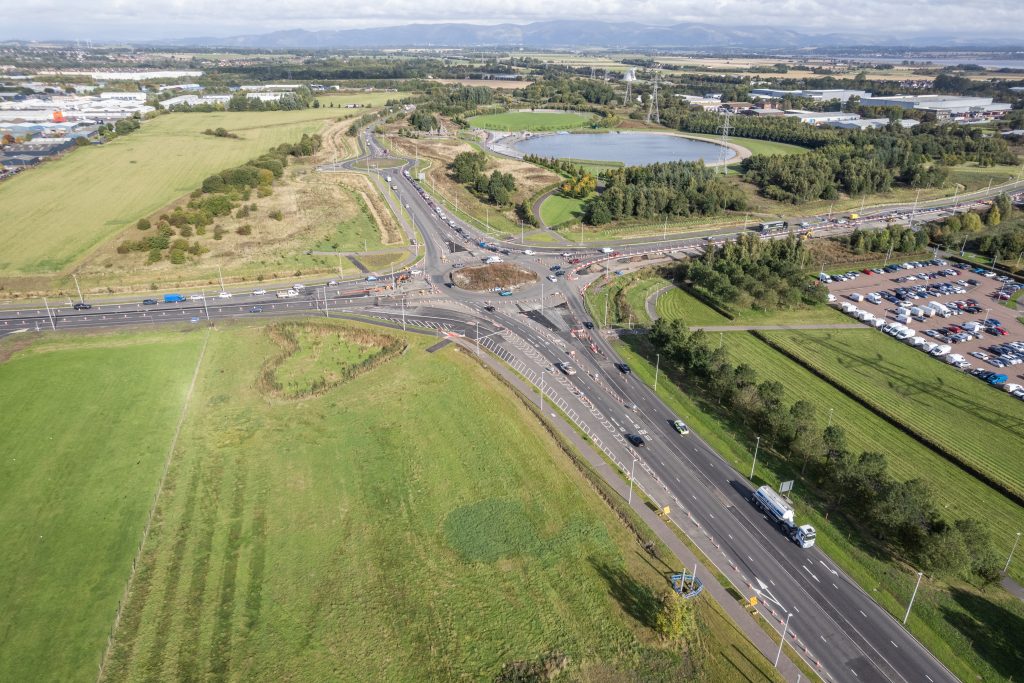

Band Drain (PVD) installation has been completed across various areas of the site. These areas will be surcharged over the coming months with imported material to impose the required load…Read More

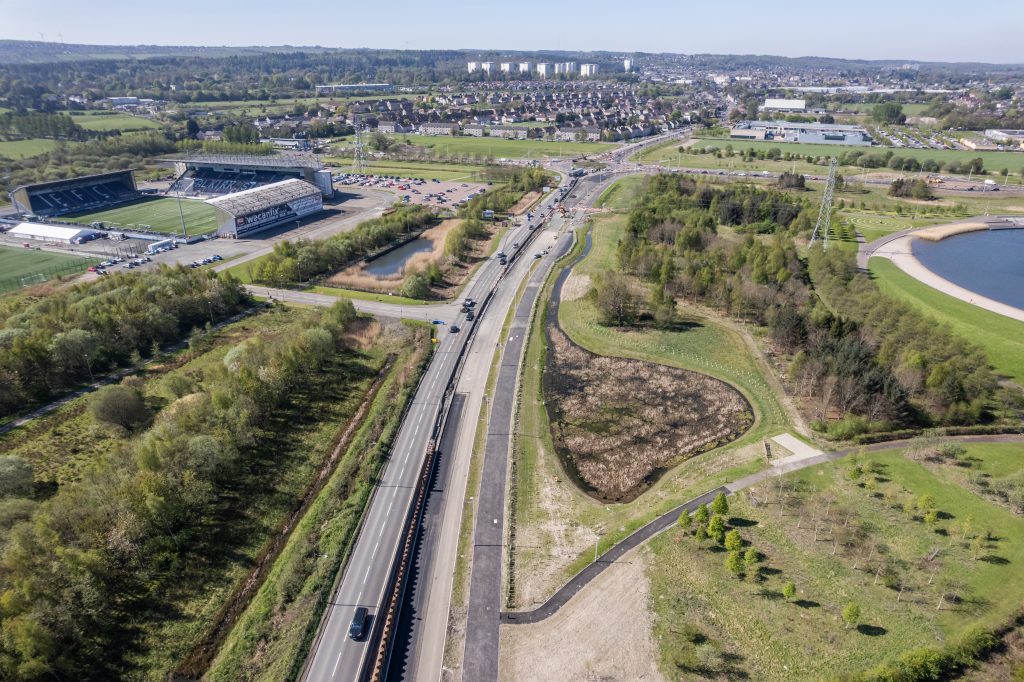

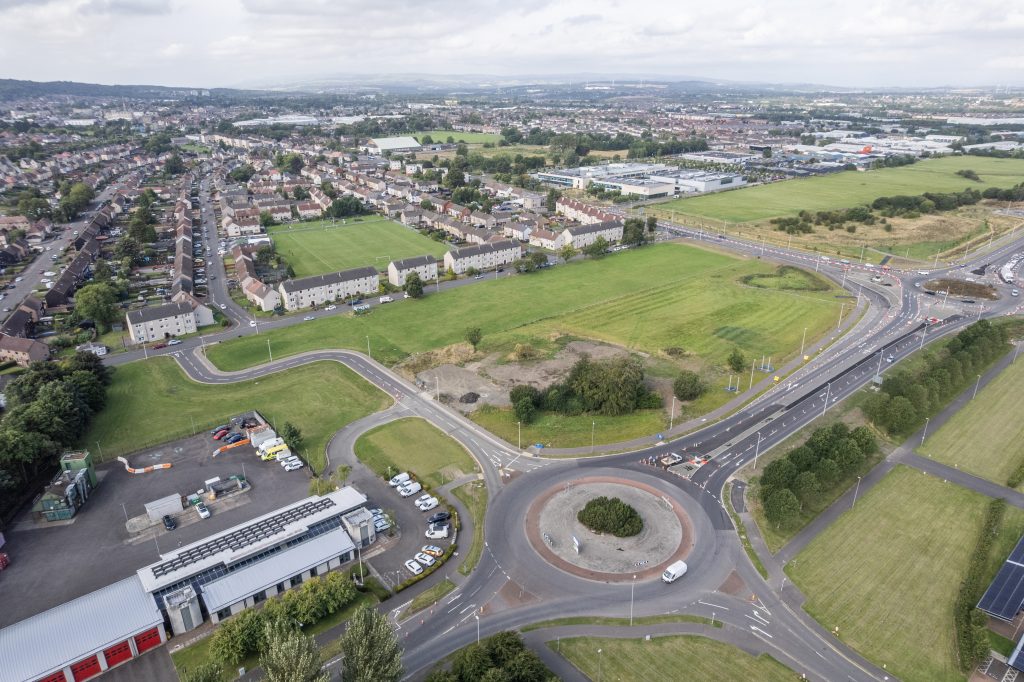

The construction of the permanent drainage ponds and swales continues with a number of these completed over the last few weeks. Works have re-commenced within the Stadium round about to…Read More

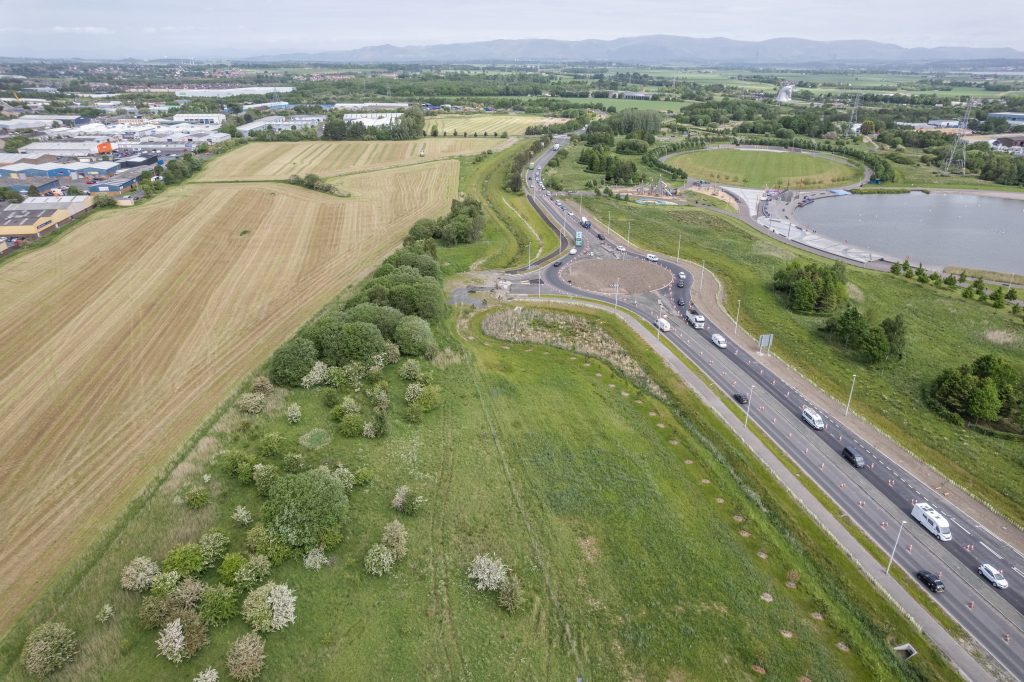

Leader of Falkirk Council, Councillor Cecil Meiklejohn, outlines the plans behind the Westfield improvement project. Earthworks for the new carriageway and for the permanent surface water drainage, in the form of…Read More
Due to the Christmas and New Year shut down there is no project update for January.

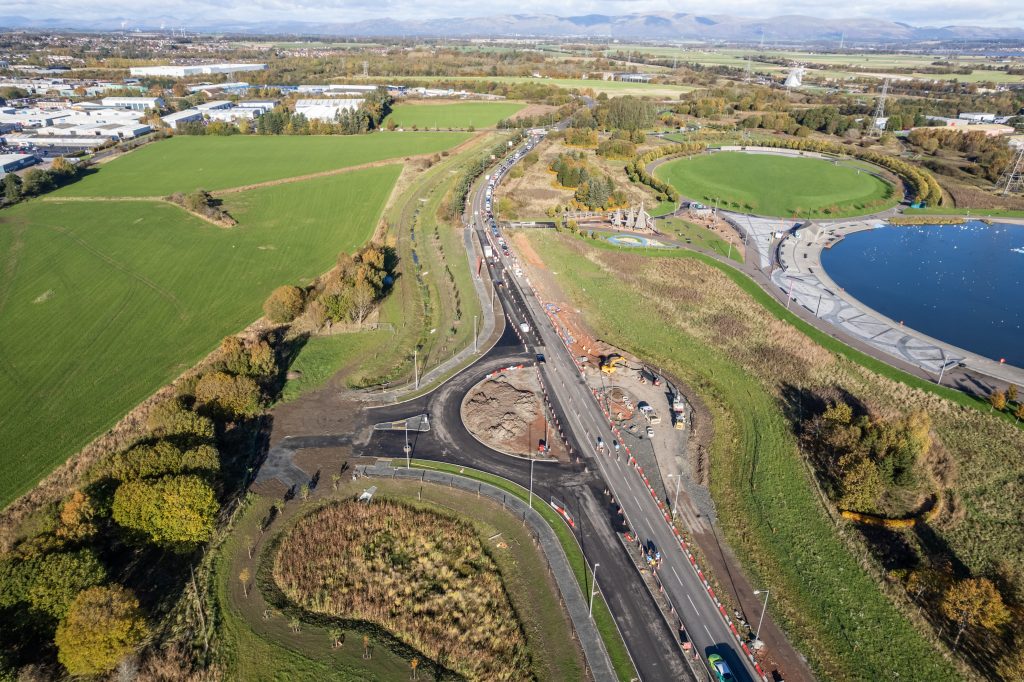

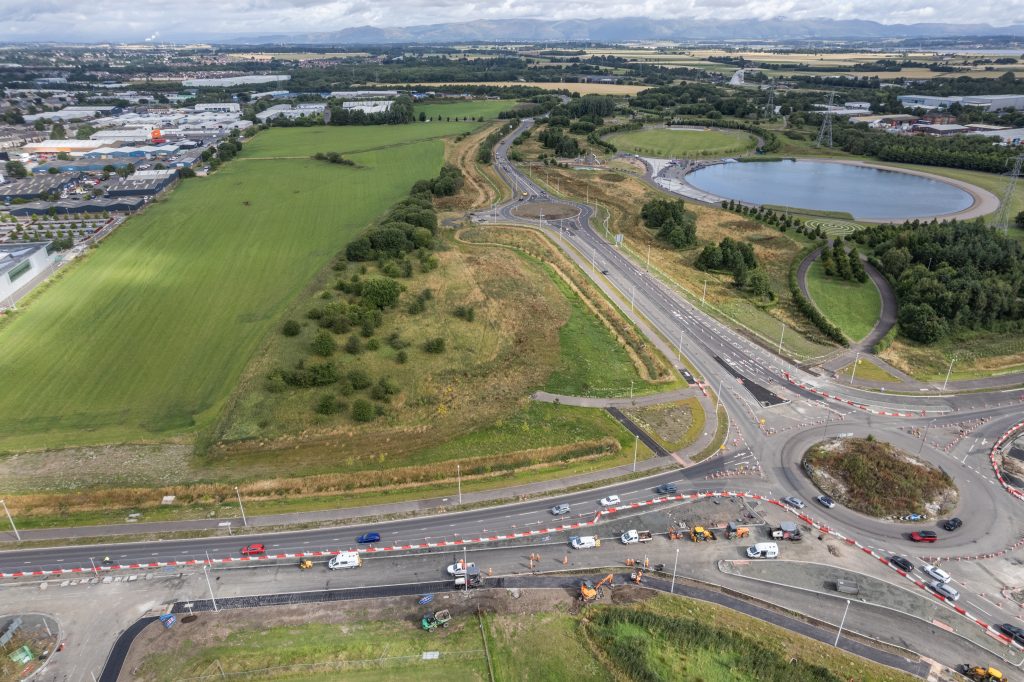

Re-surfacing works to Earl’s gate roundabout have been completed. Balfour Beatty would like to take this opportunity to thank everyone for their patience and understanding throughout the duration of these…Read More

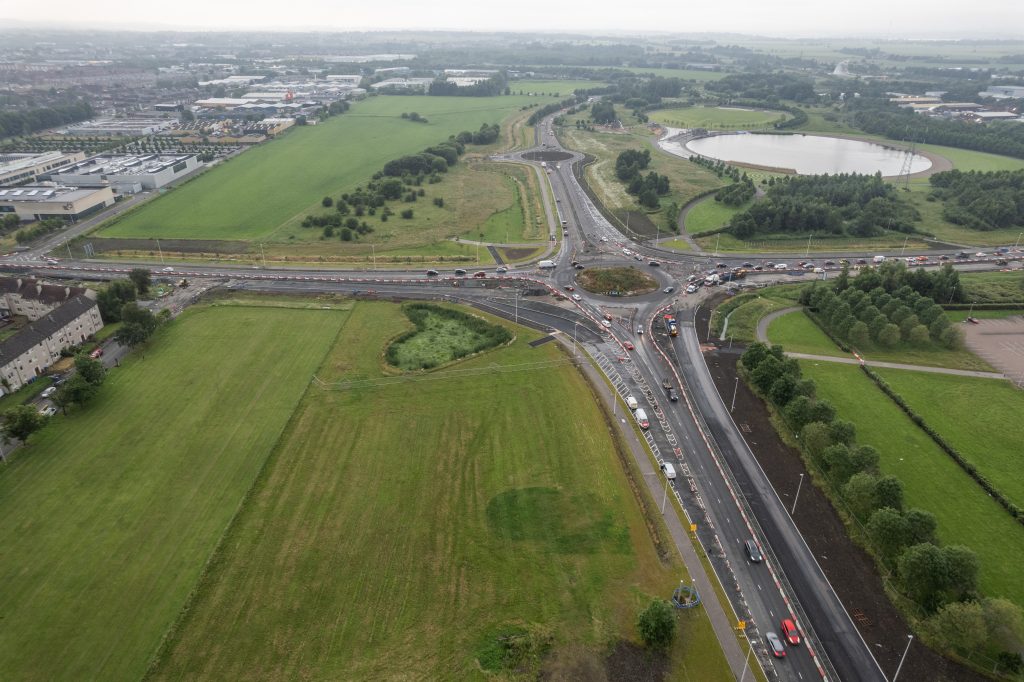

Works are now well underway at the A9 A904 Improvements project. Re-surfacing work to upgrade Earl’s gate roundabout is progressing well and due to be complete by the end of…Read More
